Trade Quantity TakeoffCSI Division 23 Measurement

HVAC Quantity Takeoff Services

ConstructQuant provides paid, project-based HVAC quantity takeoff services for US mechanical subcontractors, sheet metal fabricators, and preconstruction estimators. We perform rigorous drawing-based measurement across commercial air distribution, mechanical equipment schedules, hydronic piping, and thermal insulation—generating verified ductwork weights, linear footages, fitting counts, and unpriced Bills of Materials so your mechanical team can apply internal shop fabrication costs, regional labor rates, and supplier discounts.

Most HVAC quantity fees equal $150–$1,000, scaled to duct weight. Poundage files are usually closed in 24–48 hours.

Request an Estimate

Share your project details. Fields marked * are required.

Contact and project details
Include + and your international calling code.

Project Drawings (optional)

PDF, CAD/BIM, Office, ZIP or image documents. Up to 5 files, 25 MB each; account limits also apply.

Upload only documents you are authorized to share. Privacy policy. This request does not opt you into marketing messages.

Scope, CSI, and industry tools

What an HVAC quantity takeoff counts

Duct, equipment, and piping are measured. Pricing is left off this file.

CSI MasterFormat: Division 23 Heating, Ventilating, and Air Conditioning.

  • Duct surface area converted to pounds by gauge
  • Diffusers, grilles, and VAV boxes, each
  • Equipment from the mechanical schedule, each
  • Hydronic pipe by size, in linear feet
  • Insulation liner and wrap only where specified

Tools commonly used in the industry for this scope include PlanSwift, Bluebeam Revu, and FastDUCT. Contractors often measure in those programs and then apply their own labor and supplier prices. ConstructQuant does not sell those seats, and this page does not claim a license in any of them. The file you receive is the Excel workbook and the PDF markups named in the quote.

An HVAC count in the usual fee band is often ready in 24–48 hours. A hospital or industrial set can take longer, and the quote says so.

How the fee is set · Inspect sample quantities

HVAC Takeoff vs. Cost Estimating: Understanding This Service

This page covers unpriced HVAC quantity takeoff—the precise extraction of physical material quantities (ductwork linear feet, sheet metal weight, fitting counts, air terminals, and mechanical equipment counts) formatted into an auditable Bill of Materials. If your team requires complete unit pricing, shop fabrication hours, field installation labor, equipment buyouts, and bid summaries, please visit our HVAC Estimating Services page or explore general Quantity Takeoff Services.

What HVAC Quantity Takeoff Covers (CSI Division 23)

Commercial HVAC systems represent one of the most material-intensive and geometrically complex trades in building construction. Quantifying mechanical drawings requires precise cross-referencing between mechanical floor plans (M-series), roof layouts, enlarged mechanical room details, and equipment schedules to capture every duct transition, terminal device, and piping run.

ConstructQuant extracts physical quantities across all air distribution and hydronic systems, converting drawing dimensions into fabrication-ready sheet metal weights, standard pipe lengths, and verified equipment tallies:

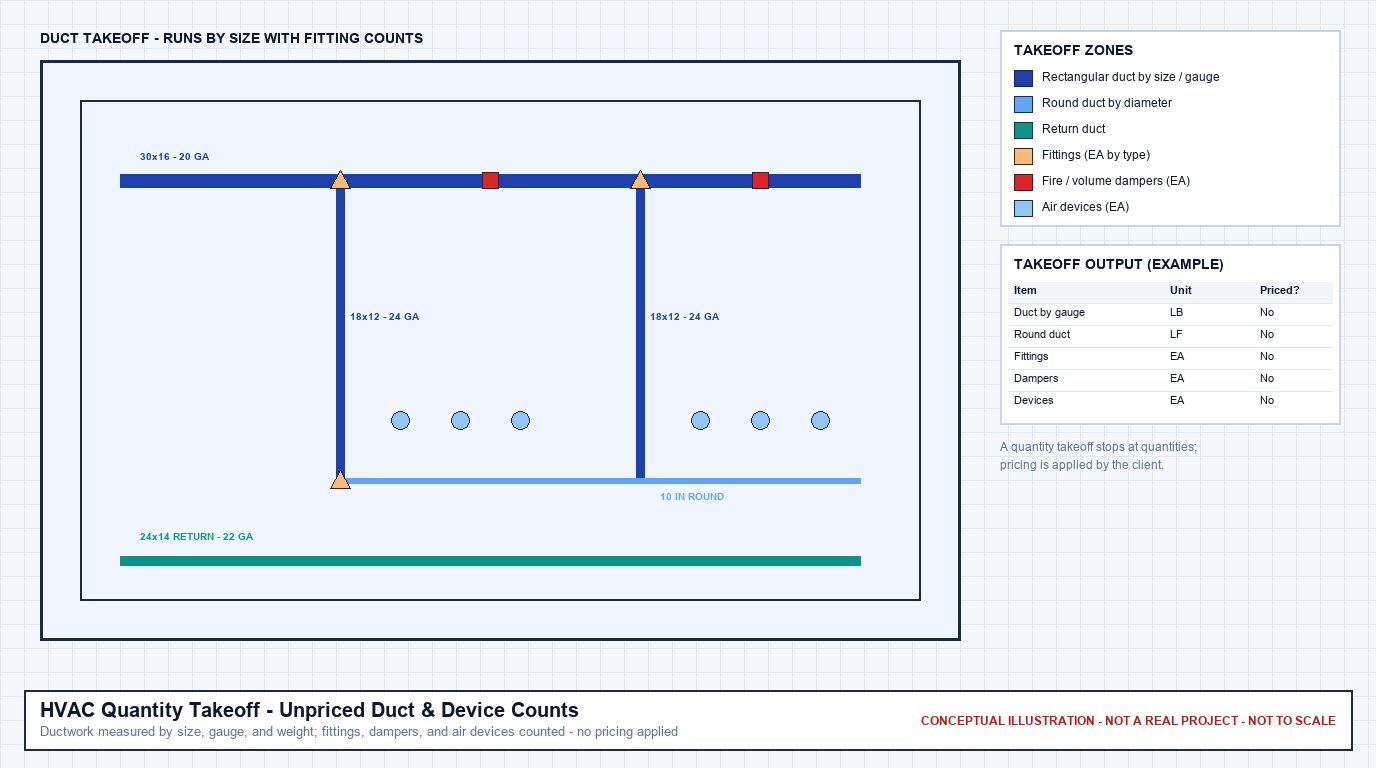

Conceptual duct takeoff showing rectangular ducts labeled by size and gauge, round duct, fittings, dampers, and air devices, with an example unpriced takeoff output table
Illustrative Estimating Workflow

Mechanical Drawing Quantification & Sheet Metal Takeoff

Every duct run, fitting, air terminal, and mechanical equipment item is traced directly from M-series drawings and verified against mechanical schedules to produce an unpriced, auditable Bill of Materials.

1. Ductwork by System & Pressure Class

Quantified by cross-sectional dimension, shape, and SMACNA gauge thickness:

  • Rectangular Ductwork: Supply air, return air, outside air, and exhaust air runs measured in linear feet (LF) and converted to sheet metal pounds (lbs).
  • Spiral & Round Ductwork: High-pressure primary supply duct, exposed architectural spiral duct, and round branch runs.
  • Flexible Ductwork: Insulated flex duct connections from VAV discharge to diffusers, quantified by diameter and standard run length.

2. Duct Fittings & Accessories

Itemized counts and poundage allowances for sheet metal shop fabrication:

  • Transitions & Offsets: Reducers, square-to-round transitions, and directional offsets around structural steel.
  • Elbows & Tees: 90-degree and 45-degree radiused and mitered elbows with turning vanes, bullhead tees, and conical taps.
  • Access Doors & Test Ports: Hinged airtight duct access doors at fire dampers, coils, and control sensors.

3. Air Terminal Devices & Grilles

Reconciled item-by-item against diffuser schedule tags and ceiling reflected plans:

  • Supply Diffusers: 2x2 modular cone diffusers, perforated face diffusers, and architectural linear slot diffusers.
  • Return & Exhaust Grilles: Eggcrate grilles, louvered face return grilles, and door transfer grilles.
  • External Louvers: Architectural intake and exhaust louvers, bird screens, and insulated blank-off panels.

4. Dampers & Airflow Control

Fire barrier penetrations and airflow balancing components quantified by dimensions:

  • Fire & Smoke Dampers: Dynamic fire dampers, combination fire/smoke dampers, and motorized smoke exhaust dampers.
  • Balancing Dampers: Manual volume dampers (MVD) at branch takeoffs and remote cable-operated dampers.
  • Backdraft & Relief Dampers: Gravity backdraft dampers and barometric relief dampers.

5. Mechanical Plant & Terminal Equipment

Complete equipment tallies cross-checked across plans, schedules, and riser diagrams:

  • Central Plant Equipment: Air Handling Units (AHUs), Rooftop Units (RTUs), chillers, cooling towers, and commercial condensing units.
  • Terminal Units: VAV terminal boxes (cooling-only, electric reheat, hot water reheat) and fan coil units (FCUs).
  • Ventilation Fans: Roof-mounted exhaust fans (upblast/downblast), inline cabinet fans, and stairwell pressurization fans.

6. Hydronic Piping & Thermal Insulation

Associated piping and thermal protection quantified by diameter and surface area:

  • Hydronic Piping: Chilled water supply/return (CHWS/R) and heating hot water supply/return (HHWS/R) in copper and carbon steel.
  • Refrigerant Lines: Suction and liquid copper line sets for VRF/VRV systems and split systems.
  • Insulation: External fiberglass duct wrap (with FSK vapor retarder), internal acoustic liner (square feet), and preformed pipe insulation.

Mechanical Drawing & Schedule Reconciliation

A critical value of professional HVAC takeoff is resolving discrepancies between schematic design floor plans and mechanical equipment schedules. On commercial drawing sets, diffusers, terminal units, or exhaust fans shown on plan sheets frequently disagree with schedule quantities or CFM ratings.

Our Multi-Sheet Verification Protocol:

Floor Plans vs. Reflected Ceiling PlansCross-referencing mechanical supply/return diffuser layouts with architectural ceiling grid coordinates to verify device counts and avoid obstructed light fixtures.
Schedules vs. Plan CalloutsComparing air terminal schedule tags (e.g., SA-1, RA-2) and VAV schedules against physical plan placements to identify unassigned or duplicate air devices.
Risers vs. Plan Floor-to-Floor HeightsCalculating vertical duct and pipe riser drops using architectural section cuts and ceiling interstitial plenum dimensions rather than flat 2D measurements.
Addenda & Revision LogAuditing cloud revisions, engineer bulletin drawings, and addenda changes to ensure the quantity takeoff reflects the exact current bid-set issue date.

Confirmed Takeoff Deliverables

Every HVAC quantity takeoff project completed by ConstructQuant includes five standard, fully auditable deliverables:

1. Excel Quantity Takeoff Worksheet (Itemized BOM)

A structured, unpriced Bill of Materials organized by mechanical system (supply, return, exhaust, outside air). Details duct dimensions, standard gauges, linear footage, calculated sheet metal weight (lbs), fitting counts, and equipment tallies ready for contractor pricing import.

2. Color-Coded PDF Plan Markups

High-resolution PDF mechanical drawing sets with visual color overlays distinguishing supply air ductwork (blue), return air (yellow), exhaust air (green), hydronic piping (red/purple), and air devices with clear legend keys.

3. Excel Estimate (When Requested with Cost Modeling)

When contracted for full estimating, we provide unit material buyouts, shop fabrication labor hours, field erection labor, and equipment rental rates formatted in an open-formula workbook.

4. Bid Summary Worksheet

A consolidated executive summary categorizing total sheet metal poundage, linear footage totals by duct type, total air terminal count, and equipment schedule totals for rapid tender review.

5. Scope & Assumptions Narrative

A formal written narrative documenting drawing sheet numbers reviewed, revision issue dates, SMACNA duct construction assumptions, equipment schedule cross-references, and explicit scope exclusions.

Our 6-Step HVAC Takeoff Workflow

Every mechanical takeoff follows our standardized preconstruction quality workflow:

Step 1

Plans/Documents

Intake and index all M-series drawings, specifications, reflected ceiling plans, and addenda bulletins.

Step 2

Scope Review

Analyze mechanical specifications, SMACNA pressure classifications, duct materials, and equipment schedules.

Step 3

Quantity Takeoff

Trace all ductwork runs, calculate sheet metal weight, enumerate fittings, air devices, and equipment counts.

Step 4

Pricing (When Opted)

Apply regional trade labor rates, sheet metal fabrication hours, and equipment buyouts when estimating is requested.

Step 5

QA/QC Review

QA/QC verification of duct formulas, CFM reconciliations, scale ratios, and markups.

Step 6

Final Delivery

Transmit completed Excel takeoff workbooks, color-coded PDF markups, and scope narrative to your estimating team.

Frequently Asked Questions (HVAC Takeoff)

How do you calculate ductwork poundage from linear dimensions?

We determine sheet metal weight by calculating the perimeter surface area of each duct section based on drawing width and height, cross-referencing specified SMACNA pressure classes to identify the required sheet metal gauge (e.g., 24 ga, 22 ga, 20 ga, 18 ga), and applying standard galvanized steel density factors per square foot.

Does this service include pricing, or is it strictly unpriced quantities?

This service provides unpriced drawing measurements and material counts (linear feet, sheet metal pounds, air device tallies, equipment counts) in an auditable Excel Bill of Materials. If your team requires full dollar pricing including regional labor rates and markups, please request our HVAC Estimating Services.

What is your typical turnaround time for an HVAC quantity takeoff?

Most HVAC quantities are typically logged in 24–48 hours. Turnaround is project-dependent based on the total sheet count, building square footage, system complexity, and whether hydronic piping takeoff is included. When you submit your mechanical drawings, we provide a confirmed delivery schedule in our formal service proposal.

How do you handle fire dampers and smoke dampers?

We cross-reference mechanical drawings against architectural life-safety plans to ensure every rated partition or floor slab penetration includes an appropriate fire, smoke, or combination fire/smoke damper along with required access doors and sleeves.

Inspect the sample deliverables

Inspect plumbing, mechanical and electrical quantities in the coordinated MEP excerpt, with drawing previews and recorded CSI divisions. The excerpt demonstrates the quantity format; it is not evidence of a completed project in a particular industry.

View sample quantities and drawing previews

Samples show selected quantities rather than commercial prices or a fee schedule. Your estimating fee, requested deliverables and delivery date are agreed per project.
