Masonry Estimating Services

ConstructQuant provides paid, project-based masonry estimating services for US masonry subcontractors, general contractors, and commercial developers. We perform precision drawing-based takeoffs across concrete masonry units (CMU), architectural face brick, stone veneer, core-fill grout, joint reinforcement, and through-wall flashings—applying regional mason and tender crew labor rates, scaffolding allowances, and material buyouts to deliver bid-ready masonry cost estimates.

Full Masonry Estimating vs. Measurement Takeoff

This service provides complete commercial masonry estimating and cost modeling—combining physical drawing takeoffs (block/brick counts, mortar bags, grout volume, rebar tonnage) with regional mason crew labor, scaffolding access, equipment rentals, and contractor markups. If your team only requires unpriced material quantities, explore our general Quantity Takeoff Services or the Construction Estimating Services master hub.

What Commercial Masonry Estimating Covers (CSI Division 04)

Commercial masonry construction demands rigorous accounting of both structural and architectural assemblies. Unlike simple square-foot estimating, professional masonry estimation requires cross-referencing structural wall sections, architectural building elevations, window schedules, and lintel details to accurately compute unit counts, mortar consumption, reinforced grout cells, and perimeter tie connections.

ConstructQuant models load-bearing CMU structures, exterior cavity wall veneers, partition walls, and specialty architectural masonry:

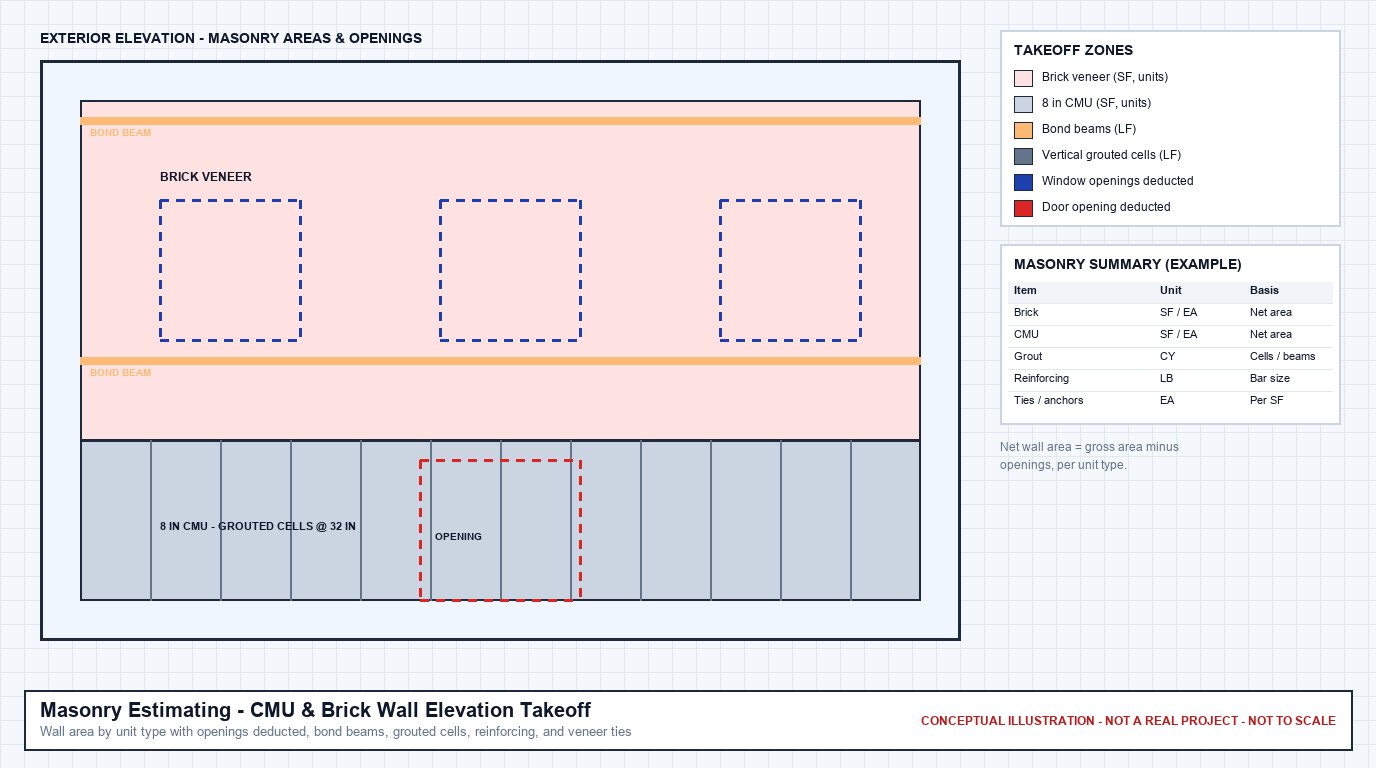

Conceptual exterior elevation showing brick veneer above 8-inch CMU, bond beams, grouted cells, and window and door openings deducted, with an example masonry summary
Illustrative Estimating Workflow

Masonry Elevation Takeoff & Structural Assembly Cost Modeling

Every block height course, bond beam elevation, door/window jamb return, lintel bearing, and wall tie spacing is traced directly from contract drawings and priced with project-specific trade inputs.

1. Concrete Masonry Units (CMU)

Structural and partition block quantified by nominal wall thickness:

  • Standard Block: 4", 6", 8", 10", and 12" lightweight and normal-weight hollow concrete blocks measured in net wall square footage and unit count (1.125 blocks per SF).
  • Specialty CMU Shapes: Bond beam blocks, open-end A-blocks, H-blocks for vertical rebar, corner units, and sash blocks.
  • Architectural Finishes: Split-face, burnished, ground-face, and integrally colored architectural CMU with post-installation water repellent.

2. Clay Brick & Architectural Veneers

Exterior cavity wall veneers and commercial facade assemblies:

  • Face Brick Types: Modular (6.75 bricks/SF), standard, queen, king-size, Norman, and utility brick in running, Flemish, or stack bonds.
  • Specialty Detailing: Soldier courses, rowlock sills, corbeled brick cornices, and decorative pattern insets.
  • Stone Masonry & Trim: Natural limestone water tables, cast stone window sills, coping stones, and adhered thin stone veneers.

3. Mortar & Core-Fill Grout Volumes

Precise volumetric calculations for site mix and ready-mix delivery:

  • Mortar Batches: ASTM C270 Type S (high-strength load-bearing) and Type N (exterior veneer) bags, sand tonnage, and admixture allowances.
  • Core-Fill Grout: ASTM C476 coarse and fine grout volumes in cubic yards based on solid grouting vs. partial grouting intervals (16", 24", 32", 48" O.C.).
  • Placement Logistics: Grout pump truck rental, crane bucket hoisting, cleanout inspection holes, and mechanical consolidation.

4. Reinforcing Steel & Structural Lintels

Structural rebar schedules and opening header components:

  • Rebar Tonnage: Vertical bar dowels (#4 through #8), lap splices, horizontal continuous bond beam bars, and corner ties.
  • Joint Reinforcement: 9-gauge and 3/16" ladder wire and truss wire joint reinforcement placed at 16" vertical intervals.
  • Lintel Assemblies: Precast reinforced concrete lintels, bond beam block lintels, and structural steel loose lintels (angles/channels).

5. Cavity Flashings & Anchoring Systems

Moisture control and exterior veneer tie assemblies:

  • Through-Wall Flashing: Self-adhering membrane flashing, stainless steel drip edges, termination bars, and end dams.
  • Weep & Vent Systems: Cellular weep vents, plastic tube weeps, and mortar deflection mesh in the drainage cavity.
  • Veneer Wall Ties: Two-piece adjustable barrel anchors, continuous seismic clip wire ties, and screw-fastened stud anchors.

6. Scaffolding, Hoisting & Crew Logistics

Site operations and heavy material handling allowances:

  • Scaffolding Systems: Tubular frame scaffolding with planking, guardrails, and hydraulic mast-climbing work platforms.
  • Material Hoisting: Rough-terrain telehandler forklifts, mortar mixer rental, and material staging logistics.
  • Cold Weather Protection: Tent enclosures, temporary propane heaters, and insulated curing blankets when specified.

Masonry Quantity Takeoff vs. Cost Estimating

A critical distinction in masonry preconstruction is separating physical measurement from complete cost modeling:

Masonry Quantity Takeoff (Unpriced Measurement)Extracts net and gross wall square footage, block and brick unit counts, mortar bags, grout cubic yards, rebar lineal footage/weight, linear feet of flashing, and wall tie tallies. Delivers an unpriced Bill of Materials.
Masonry Cost Estimating (Full Price Model)Applies regional union or open-shop journeyman mason and tender hourly rates, calculates crew daily production rates (units laid per mason day), adds equipment rental, incorporates delivery freight, and structures contractor overhead and profit.

Drawings and Documents Reviewed for a Masonry Estimate

  • Architectural floor plans and elevations: Masonry wall locations, heights, and veneer areas.
  • Wall sections: Wall construction, ties, flashing, and weeps.
  • Structural masonry plans and details: Reinforcing, grouted cells, and bond beams.
  • Lintel schedule: Lintel type and size over each opening.
  • Specification Section 04 20 00: Unit types, mortar type, and grout requirements.

Typical Masonry Quantities and Units

These are the units masonry quantities are commonly reported in. The breakdown on a specific project follows its drawings, specifications, and the estimating format you ask for.

QuantityUnitNotes
Concrete masonry units by size and typeEA / SF of wallWall area converted to unit counts; openings deducted.
Brick veneerEA / SFUnit count depends on brick size and bond pattern.
Stone veneerSFBy stone type.
MortarCY / bagsDerived from unit counts and joint size.
Grout for filled cells and bond beamsCYSolid-grouted or partially grouted, per the structural drawings.
Vertical reinforcingLF / LBSBar size and spacing from the structural details.
Horizontal joint reinforcementLFBy course spacing.
Lintels, flashing, and control jointsEA / LFFrom the lintel schedule and wall details.

Confirmed Masonry Estimating Deliverables

Every commercial masonry estimate delivered by ConstructQuant includes five standard, fully auditable deliverables:

1. Excel Masonry Cost Estimate

A line-item, formula-driven Excel estimate detailing material buyouts (CMU, brick, stone, mortar, grout, rebar), mason and tender crew labor hours, scaffolding costs, equipment allowances, and contractor markups.

2. Color-Coded PDF Plan Markups

High-resolution PDF plan sheets and building elevations with color-coded overlays distinguishing block thicknesses (8" CMU vs. 12" CMU), brick veneer sections, bond beam courses, and control joint locations.

3. Excel Quantity Takeoff Worksheet

An unpriced, auditable Bill of Materials listing net/gross wall square footage, block counts by size and type, face brick quantities, mortar bag counts, core grout cubic yards, and rebar tonnage.

4. Bid Summary Worksheet

A consolidated executive summary breaking down total cost per square foot of wall, material vs. labor percentages, scaffolding/equipment subtotals, and final bid pricing for rapid tender review.

5. Scope & Assumptions Narrative

A formal written narrative identifying drawing sheet numbers reviewed, addenda incorporated, assumed daily production rates, grout lift heights, opening deduction conventions, and explicit scope exclusions.

Our 6-Step Masonry Estimating Workflow

Every commercial masonry project follows our standardized preconstruction quality workflow:

Step 1

Plans/Documents

Intake architectural elevations, floor plans, wall sections, structural notes, lintel schedules, and addenda.

Step 2

Scope Review

Analyze block/brick specifications, grout spacing schedules, bond beam requirements, and flashing details.

Step 3

Quantity Takeoff

Trace wall surface areas, calculate net unit counts, enumerate bond beams, measure rebar, and compute grout volume.

Step 4

Pricing

Apply regional trade labor wage rates, mason daily production factors, scaffolding setup, and material buyouts.

Step 5

QA/QC Review

QA/QC verification of opening deductions, grout formulas, rebar laps, and pricing integrity.

Step 6

Final Delivery

Transmit completed Excel estimate, unpriced BOM worksheet, color-coded PDF markups, and assumptions narrative.

Frequently Asked Questions (Masonry Estimating)

How do you calculate opening deductions for windows and doors?

We follow industry-standard masonry estimating practices: small openings under 10 square feet are generally not deducted because the additional cutting and fitting labor offsets the saved unit materials. Openings exceeding 10 square feet are deducted from the gross wall area, with added allowances for jamb returns and lintel bearing blocks.

How is grout volume calculated for partially grouted CMU walls?

We determine the number of vertical reinforced cores based on the specified spacing schedule (e.g., vertical rebar at 24" or 32" O.C.) plus all bond beam courses, jamb cores adjacent to openings, and lintels. We calculate the volume per cell according to CMU block size (e.g., approximately 0.25 cu ft per 8" CMU core) and convert to cubic yards with an appropriate pumping waste factor.

What is your typical turnaround time for a commercial masonry estimate?

Turnaround is project-dependent based on the total wall square footage, building height, number of elevations, complexity of architectural banding, and whether stone veneer is included. When you submit your project plans, we provide a confirmed delivery schedule in our formal service proposal.

Can you estimate masonry for historic restoration or retrofit projects?

Yes. We estimate commercial restoration scopes including repointing/tuckpointing, cracked block/brick replacement, lintel replacement, wall tie retrofitting, and historic masonry cleaning.
